| Project Analysis | Conventional Method of Construction | Prefabricated Panels |
|---|---|---|
| Schedule | ||
| Erect & Dismantle Scaffolding | 28 Days | N/A |
| Misc. Structural Steel | 8 Days | N/A |

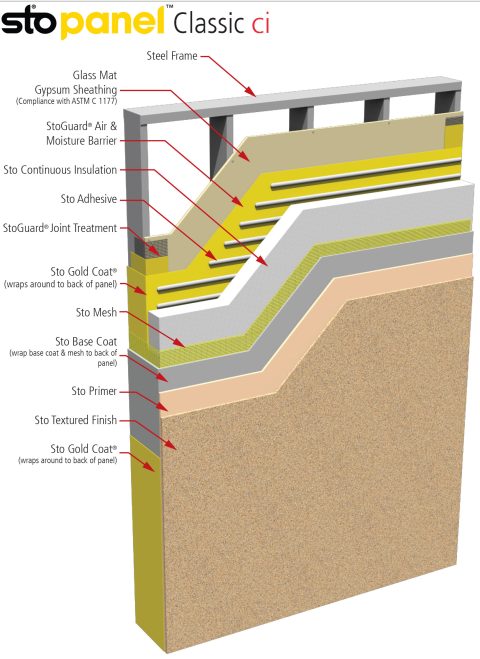

| Cold Formed Metal Framed | 20 Days | 7.5 Days |
| Sheathing | 10 Days | |
| Waterproofing | 12 Days | |
| EIFS - Stick Foam | 6 Days | |
| EIFS - Mesh & Base | 12 Days | |
| EIFS - Finish System | 6 Days | |
| Window Systems | 18 Days | |
| Flashings | 2 Days | |
| Trade Partners | ||
| Scaffolding | 1 | 1 Trade |
| Misc. Steel | ||
| Metal Framing/Sheathing | 3 | |
| Waterproofing | 4 | |
| Plaster System | 5 | |
| Window Systems | 6 | |
| Owner Savings | ||
| Schedule Savings | 26.5 Days | |
| EBITDA Savings | Schedule Savings x Revenue per Day | |
